Adjustments on time (write-ups and write-downs)

Billable time can be adjusted, so that people’s time entries are invoiced for more or less than the value of billable work. The difference between the invoiced amount and the value of billable work is shown as the “Invoiced Delta”.

Throughout the project lifecycle you may want to adjust time up or down for a number of reasons, for example:

  1. Adjust time to a rounded unit of time (e.g. rounding a 55 minute time entry to 1 hour), even though more or less time was worked (writing-down or writing-up time); or
  2. Discount a piece of work, as it has taken longer to deliver than initially quoted (writing-down time); or
  3. Invoice all time for a fixed price, regardless of how long the work took to complete.

This article includes information on:

How to make adjustments on time before invoicing

If your invoicing Billing Method is T&M (based off time and expenses), you may wish to adjust the number of hours that are included in an invoice. Users with access to make adjustments to time can adjust the billable hours of a time entry that has not been invoiced from any Time Entry list screen. These screens include:

  1. My Time Entries;

  2. All Time Entries;

  3. Person > Time Entries; or

  4. Project > Time Entries.

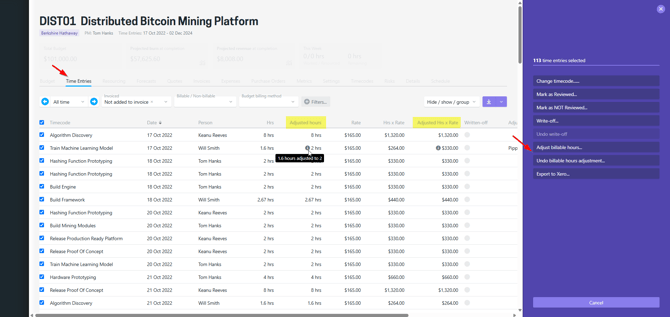

image-20250429-192711

Read more about access control →

    1. Select the time entry or time entries that you want to adjust the time for;

    2. Select “Adjust billable hours”;

    3. Enter the total number of hours that you want to update (and any time entry adjustment custom fields if required);

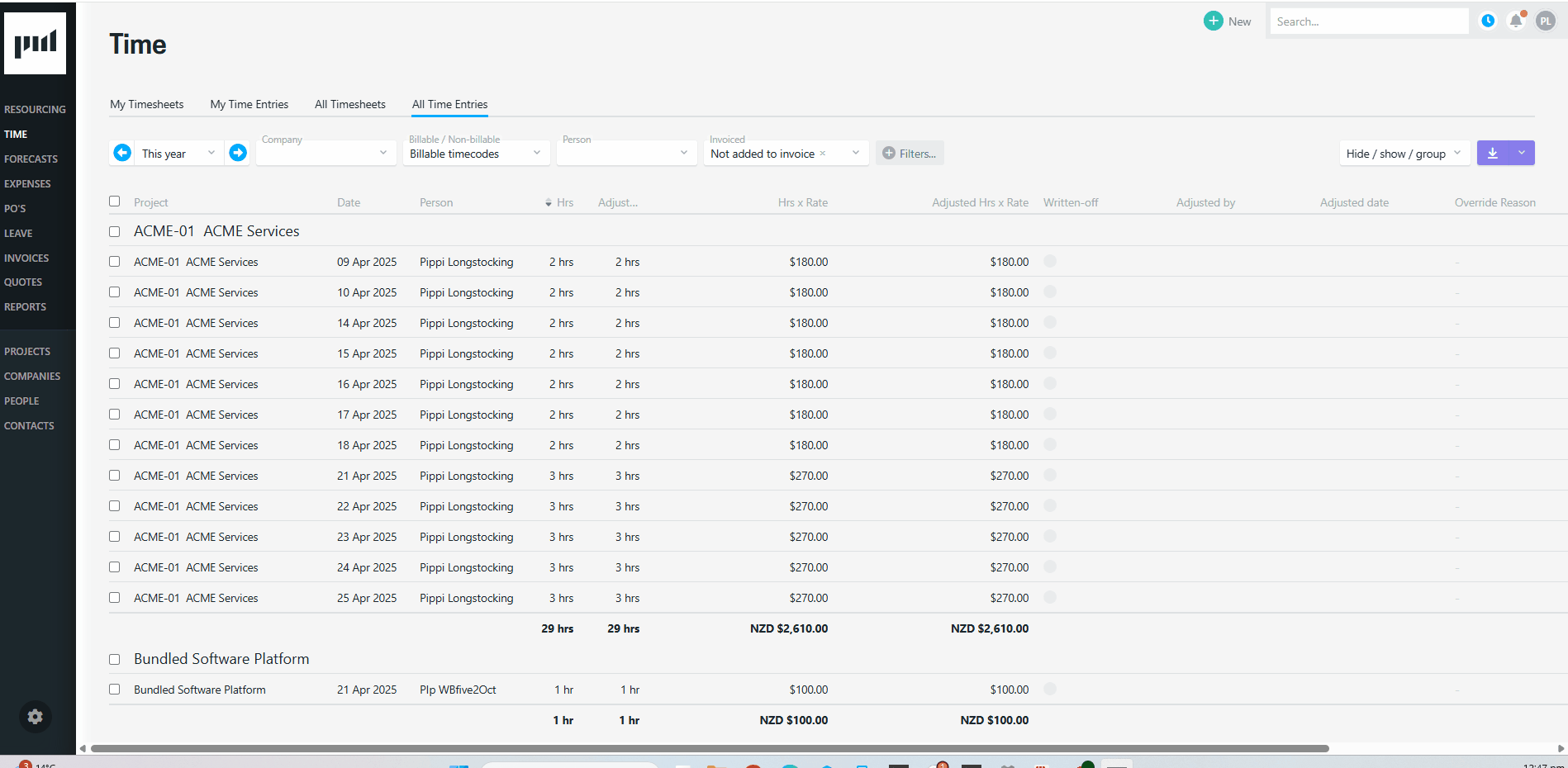

    4. Select “Proceed with action”. Adjust time entries in bulk

     The adjusted number of hours will be pro-rated across the selected time entries that can be adjusted, and the values entered for any time entry adjustment fields will be saved to all the time entries. For example, if the following four time entries have been selected:

    1. 0.92 Hrs;

    2. 0.92 Hrs;

    3. 1.17 Hrs;

    4. 1.17 Hrs;

    and adjusted to 4 hours, then the selected time entries are pro-rated down to 4 hours in total:

    1. 0.88 Hrs;

    2. 0.88 Hrs;

    3. 1.12 Hrs;

    4. 1.12 Hrs;

    You cannot adjust the billable hours of a single time entry to over 24 hours. If you enter an “Adjusted hours” value that calculates the pro-rated billable hours of one or more of the selected time entries to over 24 hours, you will encounter an error. To successfully adjust the billable hours, you will need to either:

    • Re-select the billable time entries and enter fewer “Adjusted hours”; or

    • Select more billable time entries and re-enter the “Adjusted hours”.

    If you are wanting all of the above time entries to be 1 hour, you would need to:

    1. Select the 0.92 hour time entries and adjust to 2 hours, and

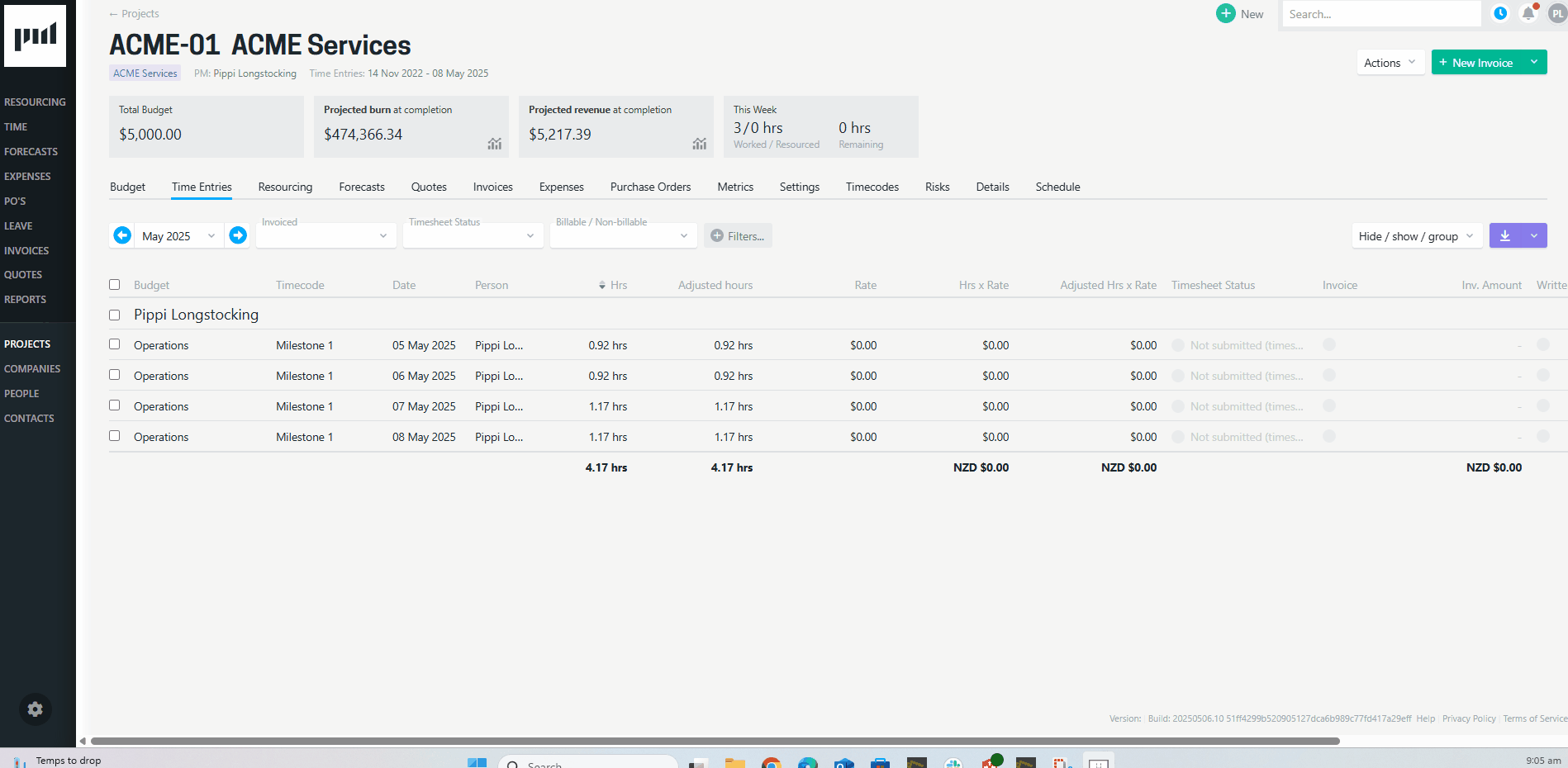

    2. Select the 1.17 hour time entries and adjust to 2 hours. Adjust time entries in bulk per time entry hours

    If time entries have been adjusted, the adjusted hours × rate will be available for invoicing. Up until the date that the time entries have been invoiced, the adjusted hours will be:

    1. Reflected in the 'Uninvoiced Time” column in the Project and Budget WIP screens; and

    2. Reflected in the the “Not Invoiced” column in the Month End Billing report.

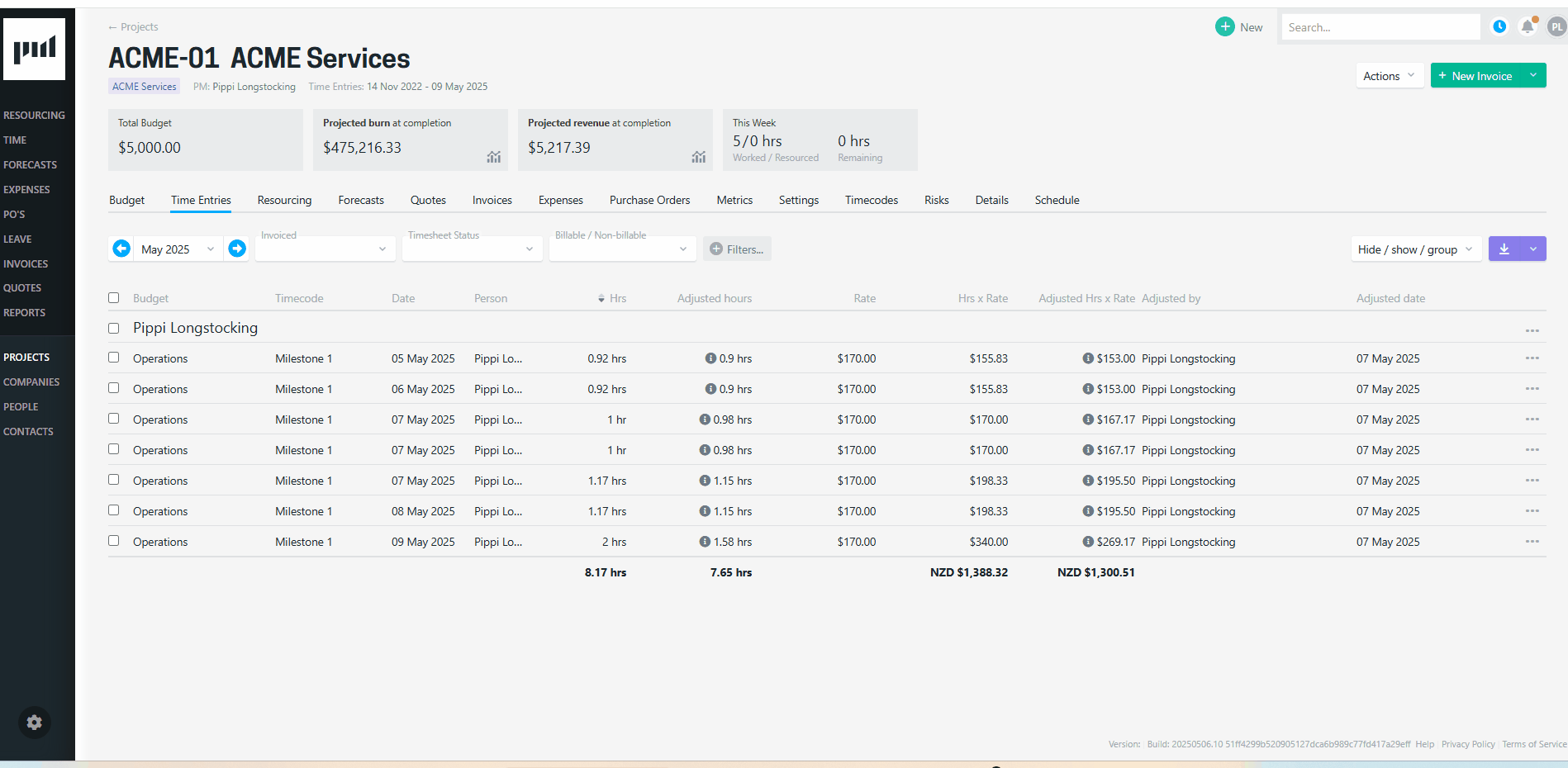

    Don’t worry! If time entries have been erroneously adjusted, you can undo the adjustment. This will remove the adjusted hours and any adjustment custom field values that were saved against the time entry.  Undo time entry adjustments

    Access Control

    Projectworks users who “Can make adjustment” to time can:

    1. Adjust billable hours;

      1. This does not impact the cost of the billable time, but enables the adjusted hours to be invoiced without adjusting the hours in an invoice, and updates the uninvoiced time entry value in the WIP (Work in Progress) and Month End Billing reports to reflect the adjusted hours rate; and

    2. Write-off time;

      1. This prevents the time entries from being invoiced and removes the time from the project’s WIP.

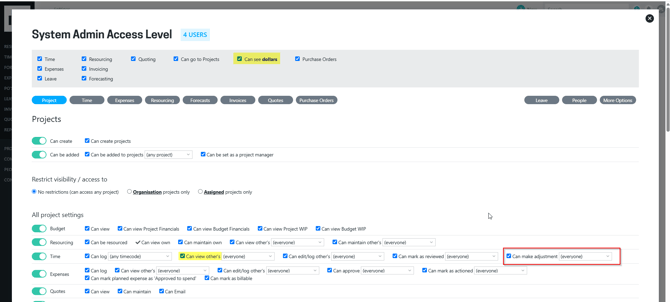

    Projectworks administrators can enable “Can make adjustment” for access levels that have access to:

    • “Can view other’s” time; and

    • Can see dollars

    Different access levels can be set to enable a person with access to make adjustments on time entries at different levels, so you may not have access to adjust or write-off all time from all time entry list screens. image-20250501-225732

    Read more about how access levels work →

    How to make invoice adjustments on time

    If time entries have not been adjusted prior to invoicing, if you are creating or editing an invoice you can adjust the time associated to an invoice budget line by ticking or un-ticking time that has been logged against the project for that invoice line.

    Time can be carried forward to be invoiced at a later date. Read more about how to carry forward time entries →

    There are a number of ways to make an invoice adjustment on a time entry on an invoice:

    1. When using a manual billing method, the qty, rate or amount can be edited; Invoicing adjustments_manual write up-gif

    2. When using the forecast or a manual billing method, time entries can be ticked or unticked for the budget; Invoicing adjustments_forecast write up-gif
    3. When using any billing method, the “Hrs” or "Days" for one or more time entries that has been selected can be overridden; Invoicing adjustments_override hours-gif

    If any of these adjustments are made, the associated time entries will be pro-rated. This can result in the time entry being written-up or written-down, dependent on the amount being invoiced, and the weighting of the time entry.

    If the billing method for a budget line in the invoice is Forecast or Manual, uninvoiced time can also be associated to the invoice line in a manager or finance approved invoice, which will update the invoice adjustment, but retain the revenue amount that has been invoiced.

    If the billing method for a budget line in the invoice is Time entries, you cannot adjust the line items of an invoice that has been manager or finance approved

    Invoicing adjustments_allocate additional time-gif

    How to carry forward time entries

    In some instances, a client may not be invoiced for work that has been carried out until a later date. When creating an invoice, you can carry forward time entries to invoice at a later date by simply unticking the:

    1. invoice budget line; or

    2. time entries

    that will be carried forward. Invoicing adjustments_carry forward time-gif

    Pro-rating invoiced amounts to time entries after invoicing

    Adjusting the time associated to a finance approved invoice is especially beneficial when you are doing a fixed price piece of work, and invoicing incrementally. This enables the revenue to be invoiced prior to the work being completed, and then allocated across the time entries as the work is undertaken.

    e.g. A new contract for $100,000 is won:

    • $20,000 to be paid on signing of the contract (February 2025) for the work that will be undertaken through to the end of October.

    1. A deposit invoice is raised in February, approved and sent to the Client for $20,000 against the “Delivery” budget.

      1. 3 hours of the Account Manager’s time (at $150 p.h.) associated to the invoice = $450.

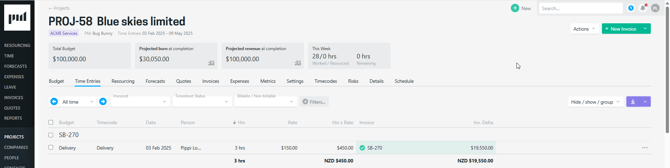

        1. Invoiced Delta = $19,550 ($20,000 minus $450) image-20250508-052155

    2. The development team enter 300 hours of time against the “Delivery” budget after February (at $100 p.h.) = $30,000 value of billable work

    3. The Project Manager retrospectively edits the February deposit invoice (for $20,000) to also include the development time.

      1. The Account Manager’s time is recalculated to $295.57 ($450 divided by ($450 + $30,000) multiplied by $20,000)

        1. Invoiced delta = -$154.43 ($295.57 minus $450)

      2. The development team’s time calculated to $19,704.43 ($30,000 divided by ($450 + $30,000) multiplied by $20,000)

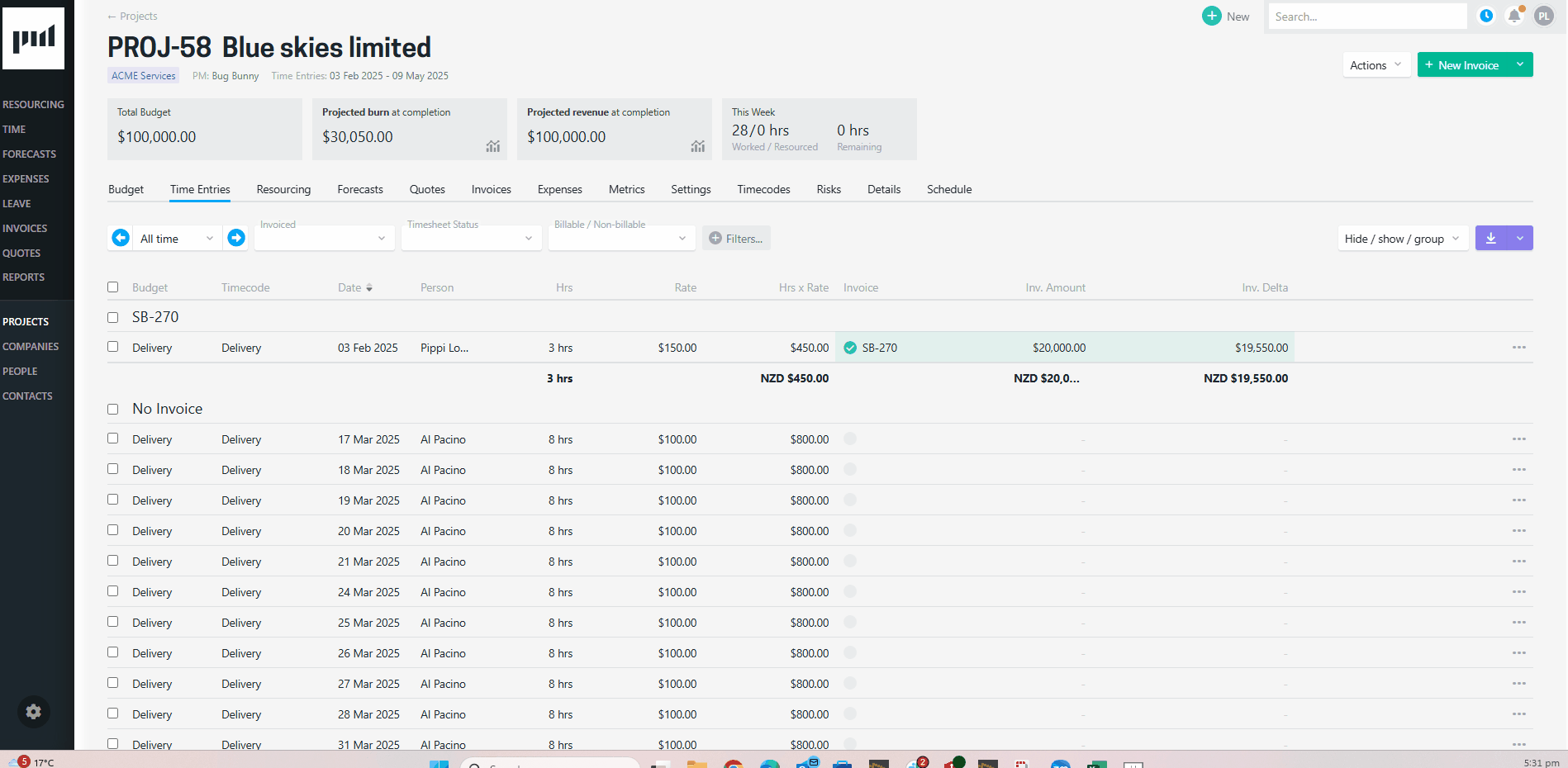

        1. Invoiced delta of -$10,295.57 ($19,704.43 minus $30,000) Invoice delta changing based on time entries inc in invoice line

    e.g. A new contract for $100,000 is won:

    • $20,000 to be paid on signing of the contract (February 2025) for the work that will be undertaken through to the end of October.

    1. A deposit invoice is raised in February, approved and sent to the Client for $20,000 against the “Delivery” budget.

      1. 3 hours of the Account Manager’s time (at $150 p.h.) associated to the invoice = $450.

        1. Invoiced Delta = $19,550 ($20,000 minus $450) image-20250508-052155

    2. The development team enter 300 hours of time against the “Delivery” budget after February (at $100 p.h.) = $30,000 value of billable work

    3. The Project Manager retrospectively edits the February deposit invoice (for $20,000) to also include the development time.

      1. The Account Manager’s time is recalculated to $295.57 ($450 divided by ($450 + $30,000) multiplied by $20,000)

        1. Invoiced Delta = -$154.43 ($295.57 minus $450)

      2. The development team’s time calculated to $19,704.43 ($30,000 divided by ($450 + $30,000) multiplied by $20,000)

        1. Invoiced Delta of -$10,295.57 ($19,704.43 minus $30,000) Invoice delta changing based on time entries inc in invoice line

    Invoiced Delta

    The Invoiced Delta displays the delta between the Invoiced Amount and the value of billable work (Hrs x Rate). The Invoiced Delta is displayed in a number of places, so you can view the write-ups and write-downs on time at a number of levels, e.g. by Project Manager, Person or Project.

    Invoiced Delta = Invoiced Amount minus Hrs × Rate

    You can view the Invoiced Delta on any time entry screen:

    • Time > My Time Entries

    • Time > All Time Entries

    • Person > Time Entries

    • Project > Time Entries

    Select the Hide/ show/ group filter and select to view the “Invoiced Delta” column. The All Time Entries screen gives you the ability to see all time entries, and group these time entries in a number of ways to give you access to the invoiced delta at a person, project or organisation level.

    You can also download a CSV, so that you can more easily interrogate the data. image-20231129-214152-png

    Troubleshooting

    The total is not shown

    If the grouping you are viewing the time entries for includes invoiced amounts in various currencies, the values cannot be shown on the screen. Hover over the “Total Not Shown” to view a breakdown of the values.

    The time entries are displayed in the incorrect unit (e.g. hrs instead of days)

    When you create an invoice, the time entries will be displayed in the unit of time that your project invoicing setting is saved to.

    Read more about invoicing with day rates →

    I cannot override a time entry to more than 24 hours

    As there are 24 hours to a day, you can only override a time entry’s time to a maximum of 24. If you enter a greater amount than 24, the Override Time will automatically revert to 24.

    image-20240117-012440-png

    If your project invoicing setting is set to days, the maximum days will be 24 DIVIDED BY Default hours per day on rate cards.

    Read more about how to set up invoicing with day rates →

    The overridden time entry is displaying an odd amount

    Much like timesheet entries, overridden time can be entered in hours or minutes i.e.:

    1. If you enter an amount in hours, with a decimal place, this will calculate to hours and minutes, e.g. 1.30 = 1 hour 18 minutes

    2. But if you enter an amount in hours with a colon, this will remain as hours and minutes, e.g. 1:30 = 1 hour 30 minutes

    If the project invoicing setting units are set to “days”, then the hours and minutes will be converted to a day quantity. For example, if the Default hours per day on rate cards is set to 8 hours, and the time entry is overridden to 1 hour and 18 minutes, then the day rate will be displayed as: 0.1625 days (78 minutes DIVIDED BY (8 × 60 minutes))

    Overridden time cannot be entered in days, even if the invoicing units are set to days.

    I don’t want to adjust time entries to 0.00 in my invoices

    Time entries can also be written-off, as opposed to adjusted to 0.00 in your invoices.

    Read more about writing-off time →
